Route 70, Route 38 to Cooper Avenue project

Evesham, Cherry Hill, and Pennsauken townships
Burlington and Camden counties

Last Update: March 19, 2025

Route 70, Route 38 to Cooper Avenue project limits map

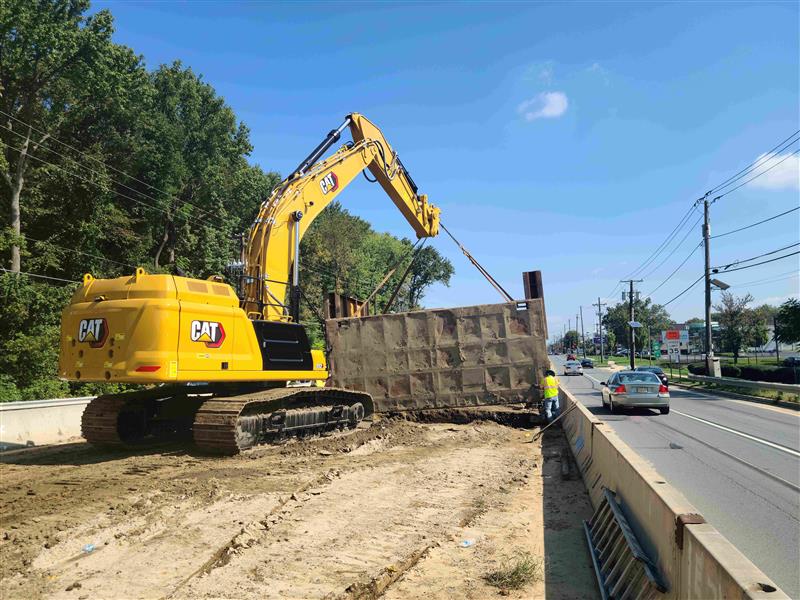

Replacing the Box Culvert for Cropwell Brook that flows beneath Rt 70 in Cherry Hill.

The New Jersey Department of Transportation is milling, resurfacing, and reconstructing 8.8 miles of Route 70 in Pennsauken, Cherry Hill, and Evesham Townships between Route 38 (Mile Post 0.00) and Cooper Avenue (Mile Post 8.80).

Scheduled Completion: Spring 2026

Project Details

The $152 million construction contract includes safety, operational and state-of-good-repair improvements for all highway users.

Roadway and Pavement Improvements
  • Full depth pavement reconstruction along three miles of Route 70
  • Reconstruct deteriorated curb and sidewalk and install new sidewalks to fill gaps and provide connectivity throughout the project limits
  • Reconstruct all 350 curb ramps to ADA standards
  • Reconstruct access to residential and business driveways that are affected by pavement reconstruction
Drainage and Structural Improvements
  • Replace existing corrugated metal culvert pipes at McClellan Avenue (MP 0.35), Cropwell's Brook (MP 3.99), and Conestoga Drive (MP 7.37)
  • Replacing the Box Culvert for Cropwell Brook that crosses beneath Route 70
  • Install six stormwater management basins and eight manufactured treatment devices for absorption into the ground and water quality
Traffic and Intelligent Transportation Systems (ITS) Improvements
  • Upgrade all 28 traffic signals within the project limits to include new electrical equipment and LED traffic signal indications. A smart technology known as adaptive traffic signal control system will be incorporated into the Route 70 corridor to interconnect all traffic signals, collect real-time traffic data, and make real-time signal timing adjustments to improve traffic flow.
  • Install new ITS fiber-optic cable throughout the project limits
  • Install new pedestrian countdown signals and pushbuttons at crosswalks
  • Upgrade five closed-circuit television (CCTV) cameras and upgrade two existing Dynamic Message Signs (DMS) locations and install two new DMS signs at MP 0.50 and at MP 1.77. DMS will alert motorists of roadway incidents or congestion
  • Upgrade lighting at signalized intersections to improve safety and replace existing streetlights with LED lighting fixtures
Utility Improvements
  • Replace 15,200 linear feet of PSE&G cast iron gas main with 18,000 linear feet of 24-inch steel gas main
  • Replace 14,500 linear feet of New Jersey American Water (NJAW) water main
  • Replace 12,168 linear feet of Merchantville Pennsauken Water Commission (MPWC) water main
  • Relocate approximately 120 utility poles to accommodate sidewalk and curb ramps
Portrait 1

Installing 24-inch Gas Main east of Cornell Intersection

Portrait 2

Installing drainage pipe east of Cooper Landing Road

Project Milestones

Work Zone #1: Route 41 Kings Highway (MP 3.66) to Grove / Haddonfield Intersection (MP 2.31)
Milestone Status Estimated Start/Finish
Gas Main Replacement Complete March 2023
Water Main Replacement Complete April 2023
Drainage In Progress Finish: Spring 2025
Traffic Signals In Progress Finish: Fall 2025
Final Paving Not Started Start: Spring 2026
Work Zone #2: Route 295 (MP 5.07) to Route 42 Kings Highway (MP 3.66)
Milestone Status Estimated Start/Finish
Gas Main Replacement Complete June 2023
Drainage Complete November 2024
Cropwell Brook Culvert Replacement Complete November 2024
Water Main Replacement In Progress Finish: Summer 2025
Traffic Signals In Progress Finish: Fall 2025
Median Reconstruction Not Started Start: Summer 2025
Final Paving Not Started Start: Summer 2025
Work Zone #3: Grove / Haddonfield Intersection (MP 2.31) to Route 38 (MP 0.0)
Milestone Status Estimated Start/Finish
Chandlers Run Culvert Replacement Complete June 2022
Gas Main Replacement Complete June 2024
Traffic Signals In Progress Finish: Winter 2026
Water Main Replacement Not Started Start: Spring 2025
Median Reconstruction Not Started Start: Summer 2025
Final Paving Not Started Start: Fall 2025
Work Zone #4: Route 295 (MP 5.07) to Cropwell Road (MP 7.67)
Milestone Status Estimated Start/Finish
Gas Main Replacement Complete December 2022
Pennsauken Creek Culvert Replacement In Progress Finish: Spring 2025
Traffic Signals In Progress Finish: Fall 2025
Water Main Replacement In Progress Finish: Summer 2025
Drainage Not Started Start: Spring 2025
Final Paving Not Started Start: Spring 2025
Work Zone #5: Cropwell Road (MP 7.67) to Cooper Ave (MP 0.80)
Milestone Status Estimated Start/Finish
Traffic Signals In Progress Finish: Fall 2025
Final Paving Not Started Start: Spring 2025

Project Completion: Spring 2026
