Department of Transportation

I-80 Eastbound Sinkhole
Last Update: April 1, 2025

OVERVIEW

The New Jersey Department of Transportation closed and detoured I-80 eastbound at Exit 34 in Wharton, Morris County on Monday, February 10 after a depression in the center lane was observed.

While NJDOT crews were conducting soil tests that night, the roadway collapsed. Crews excavated and stabilized the 11-foot by 11-foot sinkhole that was approximately four-feet deep. The compromised roadway is 75 feet away from a 40-foot by 40-foot sinkhole that was repaired in the right shoulder of I-80 eastbound near mile post 34 in late December 2024.

temporary bridge
February Sinkhole

When the sinkhole developed in February, the Department immediately began a series of geotechnical tests on I-80 eastbound and westbound to gain an understanding of subsurface conditions.


temporary bridge
Subsurface scanning

A drilling and grouting operation was undertaken to stabilize I-80 eastbound and to determine the area in which more extensive repairs are needed.

On March 19, an approximately 15-foot by 15-foot sinkhole opened up in the median in the I-80 eastbound work zone. Out of an abundance of caution, NJDOT immediately closed and detoured all lanes on I-80 westbound at Exit 34B/Route 15 northbound. Crews worked overnight to stabilize the area around the median sinkhole and tested I-80 westbound to assess the roadway’s integrity and determine what is necessary to reopen I-80 westbound.

A significant void was found under the left lane, requiring all westbound lanes to remain closed and detoured at Exit 34B until it is repaired. Final design of the I-80 westbound repairs is nearing completion, with westbound repairs beginning thereafter.

If everything progresses as planned, two lanes on I-80 westbound will be completed and reopened in approximately five weeks (early May), with the remaining lanes expected to reopen soon after.

If everything progresses as planned, the repair of two lanes on I-80 eastbound will be completed and reopened in approximately seven weeks (mid-May), with the remaining lanes expected to reopen soon after.

There will be two separate crews working concurrently – one on the eastbound side and one on the westbound side – to expedite repairs. Crews will continue working 24 hours a day until repairs are completed and the highway reopened.

temporary bridge
Drilling and Grouting
MILESTONES
Milestone Status
Establish emergency detour route Complete
Establish two-way traffic for residents Complete
Revise Signal Timing to Improve Traffic Flow Complete
Conduct Geotechnical Tests Complete
Proactive Drilling and Grouting Complete
I-80 westbound testing Complete
I-80 westbound repair Ongoing
I-80 eastbound repair Ongoing
Quality Assurance Testing Ongoing
Monitoring System Installation Ongoing
Milling and Paving Has yet to begin
I-80 westbound Reopens Early May
I-80 eastbound Reopens Expected Mid-May

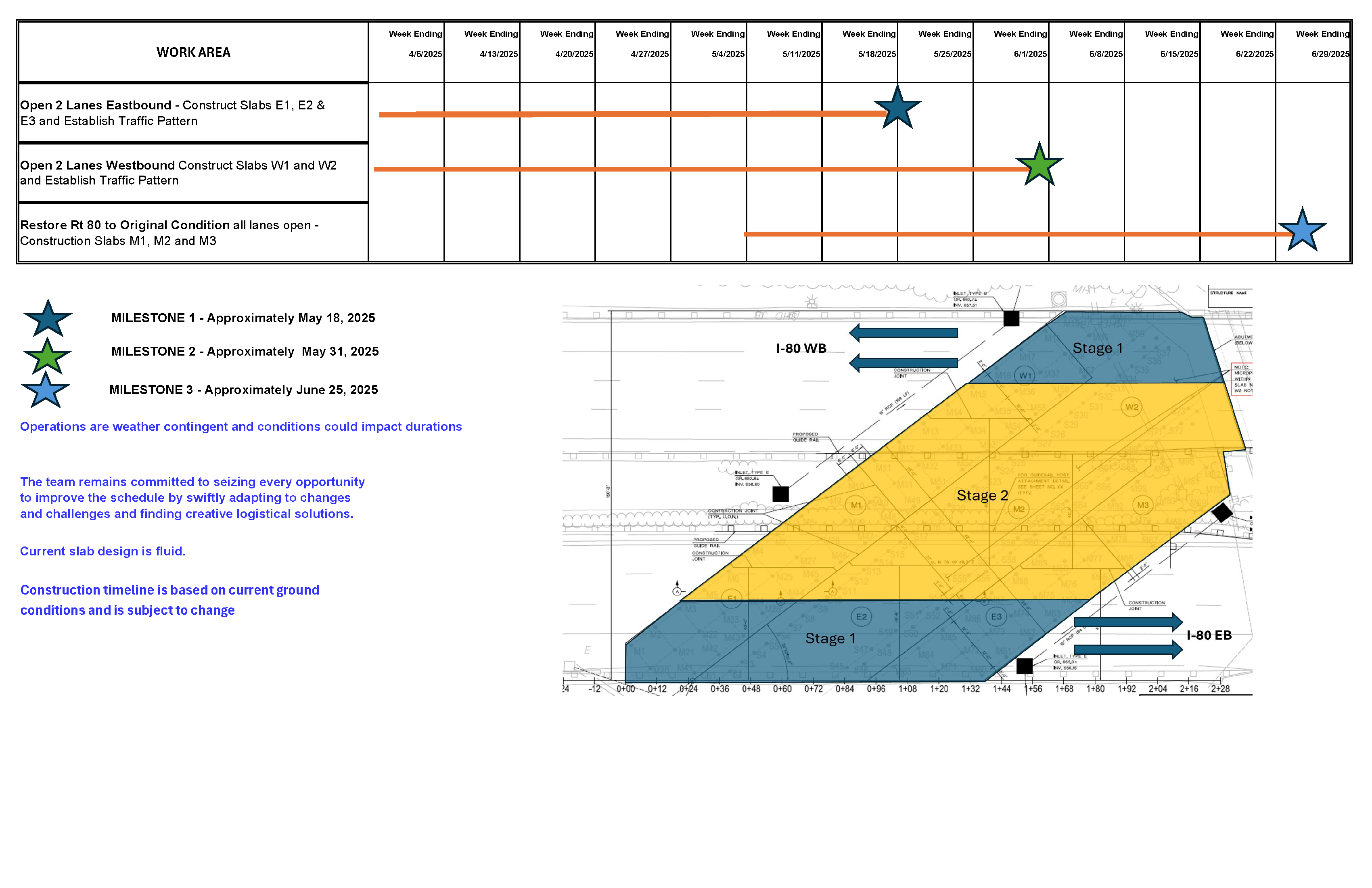

PROJECT SCHEDULE



EMERGENCY REPAIR PHASES

The path to completing emergency repairs and reopening I-80 eastbound has several phases. The timing for each phase has not yet been determined. However, the entire repair is expected to take approximately two months:

  • Geotechnical tests to assess the condition of the roadway base are complete. These tests established our work area and helped identify approximately 150 locations to drill and grout.
  • Drilling and grouting operations to probe subsurface conditions are complete. This work has stabilized the area under the roadway by filling holes and small voids and outlined the area where a more extensive repair is required.
  • Repairing I-80 eastbound and westbound is ongoing. The repair will include excavating the area, installing a base of large stone and micropiles into the bedrock to support a concrete slab. Additional fill and soil will be placed on top of the concrete and compacted before several layers of asphalt will be applied to reconstruct the road.
  • Quality assurance testing will be done while repairs are being made and following completion of the repair to ensure the long-term stability of the roadway and the integrity of the repairs.
  • Installing a monitoring system to track surface and underground conditions will be done as part of the repair. There will be three types of monitors. Remote sensing technology on poles will scan the pavement for changes, while sensors beneath the road will detect early signs of subsurface movement. Deeper underground devices will monitor long-term soil stability.
  • Milling and paving the work area for a safe, smooth driving surface and reopening the road is the final phase.


temporary bridge
Median Excavation
EMERGENCY FUNDING

Governor Phil Murphy declared a State of Emergency for Morris County on March 8 to enable access to Federal funding. The Declaration was one step in the process to apply for emergency federal funding from the Federal Highway Administration (FHWA). NJDOT is continuing to work with FHWA.


TRAFFIC MITIGATION

The Department is continuing to work closely with local officials and the New Jersey State Police to improve mobility along the detour and alternate routes in the region, including evaluating requests made by neighboring communities along Route 46 that are seeing higher volume due to the I-80 westbound closure.

NJDOT continues to adjust the timing of signals on Route 15, Route 10, and Route 46 to minimize the impact of the I-80 westbound detour. NJDOT and New Jersey State Police will continue to monitor traffic conditions and make adjustments as necessary to mitigate delays.

Motorists are advised to consider these options to help reduce delays on I-80 and the surrounding roadways:

  • NJ TRANSIT is offering a 50 percent discount on roundtrip travel for those affected by the ongoing emergency repair work on I-80. The 50 percent discount offer will remain in effect for the duration of the repairs and aims to provide an alternative travel option while alleviating congestion in the impacted area. For more information, see the NJ TRANSIT press release.

  • Consider working from home if that is an option.

  • Businesses and employees are encouraged to adjust working hours, if possible, to avoid driving during the morning and evening rush hours.

  • Please remain on the designated detours or alternate routes.

    • Due to the significant impact of the closures, GPS and other map services may reroute traffic onto local roads that are not designed to handle commercial vehicles or increased traffic volume.

    • This is particularly important for trucks as there are low bridges and weight restrictions on many roads in the area.

    • In addition, Picatinny Arsenal is a restricted Military Installation and roads through the Arsenal are not accessible to the public.

  • Follow all posted signs and regulations, and if you are approaching an intersection, please “Don’t block the box.”

  • A new I-80 travel time page has been added to www.511NJ.org and has current travel times on the detour routes and alternate routes.

In addition, NJDOT is using technology to send messages to commercial truckers to provide information about the closure, detour, and alternate routes. The Department is also using digital messaging signs and working with our regional transportation partners to share information so drivers can make informed decisions about potential alternate routes to take.


DETOURS AND ALTERNATE ROUTES

I-80 eastbound traffic is being detoured at Exit 34. The following detour remains in place:

I-80 eastbound Exit 34 Detour:

Motorists on Route 15 southbound wishing to take the bridge over Rockaway River will be directed to:

  • Motorists on I-80 eastbound are being directed to take Exit 34 to Route 15/Wharton/Dover/Sparta
  • At the end of the ramp, stay right following signs for Route 15/Jefferson/Dover/Sparta/Picatinny Arsenal
  • Stay in the right lane on North Main Street following signs for Route 15 North/Jefferson/Sparta
  • Bear right toward Route 15 northbound/Picatinny Arsenal
  • Stay left, following signs for Pondview Drive/U and Left Turns
  • Using both lanes, make a U-turn at the Pondview Drive traffic signal and merge onto Route 15 southbound
  • Stay left to take the exit to I-80 eastbound

I-80 westbound traffic is being detoured at Exit 34B. The following detour is in place:

I-80 westbound Exit 34B Detour:

Motorists on Route 15 southbound wishing to take the bridge over Rockaway River will be directed to:

  • Motorists on I-80 westbound will be directed to take Exit 34B to Route 15 north/Jefferson/Sparta
  • Keep left on Route 15 northbound
  • Use the left two left lanes at Pondview Drive to make a U-turn onto Route 15 southbound
  • Stay right to take the ramp to I-80 westbound

Route 10 eastbound Alternate Route:
  • Motorists on I-80 eastbound are advised to take Exit 28/Route 46 eastbound to Route 10/Ledgewood/Lake Hopatcong, which is several miles before the closure
  • Continue on Route 46 eastbound
  • Stay right to take Route 10 eastbound
  • Take the exit to I-287 northbound
  • Stay right to take the ramp to I-80 eastbound

Route 46 eastbound Alternate Route:
  • Motorists on I-80 eastbound are advised to take Exit 28/Route 46 eastbound to Route 10/Ledgewood/Lake Hopatcong, which is several miles before the closure
  • Continue on Route 46 eastbound
  • Stay in the two left lanes to turn left at the traffic signal to continue on Route 46 eastbound
  • Turn left onto Route 15 northbound in Dover, back to I-80
  • Stay right to take the ramp to I-80 eastbound
  • OR
  • Continue on Route 46 eastbound for about 12 miles and stay left for I-80 eastbound

temporary bridge
Location Map
Last updated date: April 4, 2025 10:56 AM
